CD Model: Stages 8-12 (Release to Production)
Introduction
Stages 8-12 of the Continuous Delivery Model cover the release, deployment, and operational phases. These stages transition validated software from testing environments into production, where it serves end users. The focus shifts from development and testing to stakeholder validation, controlled deployment, and operational excellence.
This article provides detailed explanations of each stage, including deployment strategies, approval processes, monitoring practices, and feature management.
Stage 8: Start Release
Purpose: Initiate the formal release process and prepare for production deployment.
Release Candidate Creation
Starting a release involves creating a release candidate - a specific version of software proposed for production deployment:

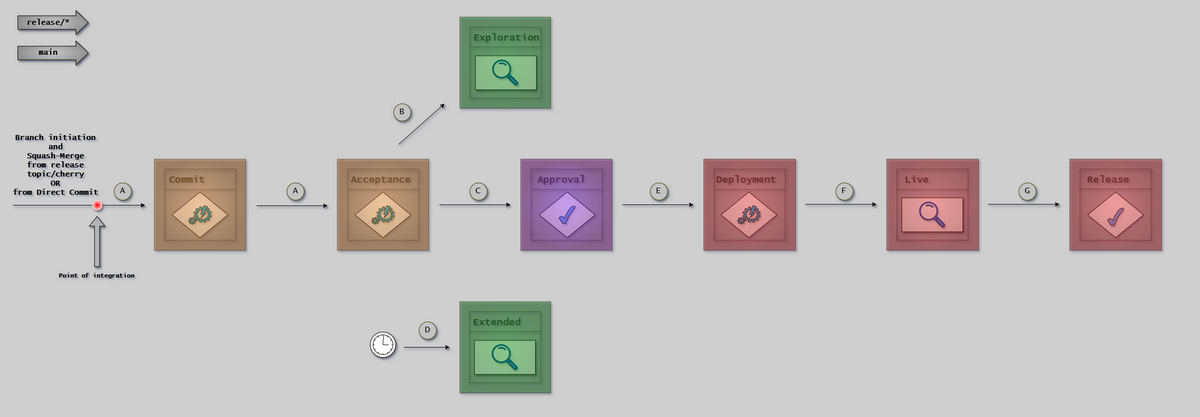

This diagram shows the release branch stage flow and progression through final stages:
- A: All commits to release branch trigger automatic Stage 4 (Commit) and Stage 5 (Acceptance Testing)
- B: After successful Acceptance Testing, software (in the case of runtime systems) automatically deploys to approval environment
- C: Head of release branch is ready for Stage 9 (Release Approval)
- D: Stage 6 (Extended Testing) periodically picks up current HEAD to inform approval decision
- E: After release approval, enters Stage 10 (Production Deployment)
- F: After deployment to production, software enters Stage 11 (Live)
- G: If using decoupled deployments, can be toggle released in Stage 12 (Release Toggling)
The first commit on a release branch is the same main branch commit it was branched from. Further changes come from release topic branches or cherry-picks from main.
Release Branch Strategy:
- Create a release branch from main (e.g.,
release/v1.2.0) - No new features added to release branch
- Only critical bug fixes allowed
- All changes cherry-picked back to main
Tagged Release Strategy:
- Tag a specific commit on main (e.g.,
v1.2.0) - No branch created
- Simpler, but requires discipline
Release Notes Generation
Comprehensive release notes document what's changing:
What to Include:
- New features: User-facing capabilities added
- Enhancements: Improvements to existing features
- Bug fixes: Issues resolved
- Breaking changes: Incompatibilities requiring user action
- Security fixes: Vulnerabilities addressed
- Deprecations: Features being phased out
- Known issues: Documented limitations
Format:
# Release v1.2.0
## New Features
- User authentication with OAuth2 providers
- Export data to CSV format
## Enhancements
- Improved search performance (50% faster)
- Better error messages for validation failures
## Bug Fixes
- Fixed crash when uploading large files (#234)
- Corrected timezone handling in reports (#245)
## Breaking Changes
- API endpoint `/old-api` removed, use `/v2/api` instead
## Security
- Updated dependencies to address CVE-2024-1234
Release notes can be auto-generated from commit messages (using semantic commits) or curated manually.
Version Tagging
Version numbers follow semantic versioning (MAJOR.MINOR.PATCH):
- MAJOR: Incompatible API changes
- MINOR: New functionality, backward-compatible
- PATCH: Bug fixes, backward-compatible
Example: v1.2.3
- 1 = Major version
- 2 = Minor version
- 3 = Patch version
Pre-release versions may include labels: v1.2.3-rc.1 (release candidate 1)
Environment
Release preparation happens on Build Agents, producing tagged artifacts ready for deployment.
Stage 9: Release Approval
Purpose: Obtain formal approval for production deployment based on quality and compliance criteria.
Approval Criteria
Before deploying to production, the release must meet defined criteria:
Quality Metrics:
- All automated tests passing (100%)
- Code coverage meets threshold (e.g., 80%+)
- No critical or high-severity bugs open
- Performance benchmarks met
- Security scans pass
Compliance Requirements:
- All required documentation complete
- Risk assessments approved
- Security reviews completed
- Regulatory requirements satisfied
- Stakeholder sign-offs obtained
Business Readiness:
- Release notes finalized
- User documentation updated
- Support team trained
- Rollback plan documented
- Communication plan ready
Manual vs Automated Approval
Manual Approval (Release Approval Pattern):
- Release manager or approval board reviews criteria
- Formal sign-off documented
- Approval recorded in tracking system
- Required for regulated environments
Automated Approval (Continuous Deployment Pattern):
- Quality gates automatically evaluate criteria
- Pipeline proceeds if all gates pass
- Approval implied by passing quality gates
- Suitable for non-regulated environments
Quality Thresholds
Automated quality thresholds might include:
| Metric | Threshold |
|---|---|
| Test pass rate | 100% |
| Code coverage | ≥ 80% |
| Critical bugs | 0 |
| High bugs | 0 |
| Performance regression | < 5% |
| Security vulnerabilities (Critical/High) | 0 |
Documentation Requirements
Required documentation for release approval:
- Release notes
- Deployment runbook
- Rollback procedure
- Test evidence
- Security scan reports
- Performance test results
- Stakeholder sign-offs
- Risk assessment
Environment
Release approval validation occurs in PLTE (automated) and Demo (exploratively) environments where evidence has been collected throughout Stages 5-7.
Stage 10: Production Deployment
Purpose: Deploy the approved release to the production environment with appropriate controls.
Deployment Strategies
Stage 10 executes production deployment using one of five strategies. For detailed strategy comparison and selection guidance, see Environments: Production Environment and Deployment Strategies.
Quick Reference:
- Hot Deploy: Fastest, brief downtime
- Rolling: Zero downtime, gradual
- Blue-Green: Instant rollback, 2x cost
- Canary: Metrics-driven, 1-5% initial
- Rings: User-segment phased rollout
Deploy Agents and Segregated Access
Some Production deployments use Deploy Agents - specialized CI/CD runners with:
- Network segregation: Access to production networks
- Credentials: Production deployment credentials (stored securely)
- Audit logging: All deployment actions logged
- Principle of least privilege: Only necessary permissions
Deploy agents are typically the only automated systems allowed to deploy to production.
Rollback Planning
Every deployment must have a rollback plan:
Automated Rollback Triggers:
- Error rate exceeds threshold
- Latency exceeds acceptable limits
- Health checks fail
- Key metrics regress
Rollback Procedures:
- Revert to previous version
- Restore database if schema changed
- Clear caches if necessary
- Verify rollback success
Rollback Time Objective:
- Define target time to roll back (e.g., < 5 minutes)
- Practice rollback procedures regularly
- Automate rollback where possible
Monitoring During Deployment
Closely monitor during and immediately after deployment:
- Error rates: Watch for increased errors
- Latency: Monitor response times
- Resource utilization: Check CPU, memory, disk
- Business metrics: Verify key workflows working
- User reports: Monitor support channels
Use dashboards that highlight deployment events to correlate changes with metric shifts.
Environment
Deployments target the Production Environment using Deploy Agents with segregated network access.
Stage 11: Live
Purpose: Monitor and validate the release in the production environment.
Production Monitoring
Once deployed, continuous monitoring ensures the release behaves correctly:
Infrastructure Monitoring:
- Server health (CPU, memory, disk, network)
- Container health (if using containers)
- Database performance (query times, connection pools)
- Network latency and packet loss
Application Monitoring:
- Request rates and response times
- Error rates and types
- Active users and sessions
- Feature usage
Business Monitoring:
- Conversion rates
- Transaction volumes
- User engagement
- Revenue metrics
Metrics and Thresholds
Define acceptable ranges for key metrics:
| Metric | Threshold | Action |
|---|---|---|
| Error rate | < 0.1% | Alert if exceeded |
| P95 latency | < 200ms | Alert if exceeded |
| CPU utilization | < 70% | Alert if sustained |
| Memory usage | < 80% | Alert if sustained |
| Active users | Monitor | Trend analysis |
Alerts should be actionable - every alert should require a response.
Phased Rollout (Rings)
Instead of deploying to all users simultaneously, use rings:
Ring 0 - Canary (1-5% of users):
- Internal users or beta testers
- Early warning of issues
- 1-4 hours monitoring
Ring 1 - Early Adopters (10-25%):
- Users who opted into early access
- Broader validation
- 24 hours monitoring
Ring 2 - General Availability (100%):
- All users
- Full production rollout
Each ring provides validation before expanding to more users.
Incident Response
When issues occur in production:
- Detect: Monitoring alerts or user reports
- Triage: Assess severity and impact
- Respond:
- Roll back if critical
- Apply hot fix if minor
- Mitigate impact (disable feature, redirect traffic)
- Communicate: Update status page, notify users
- Resolve: Fix root cause
- Post-mortem: Learn and prevent recurrence
Environment
Live monitoring tracks the Production Environment where end users interact with the software.
Stage 12: Release Toggling
Purpose: Control feature availability using feature flags (optional).
Feature Flags Explained
Feature flags (or toggles) allow runtime control of feature availability without redeployment:
if featureFlags.IsEnabled("new-checkout-flow", user) {
// New checkout implementation
} else {
// Old checkout implementation
}
Flags provide granular control:
- Enable/disable features instantly
- Gradual rollout to percentage of users
- A/B testing different implementations
- Emergency kill switch
When to Use Feature Flags
Use feature flags for:
- Large features: Break into smaller, independently deployable pieces
- Experimental features: Test with subset of users
- Risky changes: Quick rollback without redeployment
- Phased rollouts: Gradual exposure (10% → 50% → 100%)
- Business events: Activate features at specific times
Avoid feature flags for:
- Small, low-risk changes
- Bug fixes (use proper fixes instead)
- Technical debt (create time-boxed flags only)
Implementation Patterns
Simple Boolean Flag:
Percentage Rollout:
User-Targeted Flag:
features:
admin-panel:
enabled_for_users: ["admin@example.com"]
enabled_for_groups: ["administrators"]
Time-Based Flag:
features:
black-friday-sale:
enabled_after: "2024-11-29T00:00:00Z"
enabled_before: "2024-12-02T00:00:00Z"
Risk Mitigation
Feature flags mitigate deployment risk:
- Decouple deployment from release: Deploy code OFF, enable later
- Instant disable: Turn off problematic features immediately
- Gradual validation: Expose to small audience first
- A/B testing: Compare feature variations
Flag Lifecycle Management
Avoid flag accumulation:
- Create: Add flag when deploying unfinished/risky feature
- Enable: Gradually roll out to users
- Stabilize: Monitor and iterate
- Remove: Delete flag after feature proven stable (30-90 days)
Treat feature flags as technical debt - clean them up regularly.
Environment
Feature flags operate in the Production Environment, providing runtime control without redeployment.
Summary
Stages 8-12 bring software to production and manage it operationally:
- Stage 8: Release candidate creation and documentation
- Stage 9: Formal approval (manual or automated)
- Stage 10: Production deployment with chosen strategy
- Stage 11: Monitoring and validation in production
- Stage 12: Feature flag management (optional)
These stages emphasize controlled release, comprehensive monitoring, and risk mitigation through techniques like staged deployment, feature flags, and automated monitoring.
Next Steps
- CD Model Overview - Return to the overview
- Stages 1-7: Development to Testing - Review earlier stages
- Implementation Patterns - Choose RA or CDE pattern
- Environments - Understand environment architecture
References
Tutorials | How-to Guides | Explanation | Reference
You are here: Explanation — understanding-oriented discussion that clarifies concepts.
